What Is Contract Logistics? Models, Pricing, and What’s in the Contract

Contract logistics means outsourcing your warehousing, fulfillment, and shipping to an outside provider under a long-term contract. The provider runs the operation. You keep the stock and the customer. Most agreements run for years, not months. Each one states what the provider must deliver, what it costs, and what happens if service slips.

What is contract logistics?

Contract logistics is outsourced warehousing and fulfillment governed by a formal, long-term contract. A provider stores your goods, picks and packs orders, and ships them. You pay agreed rates and hold the provider to agreed service levels.

The word that matters is contract. Plenty of companies will store your pallets on a handshake and a monthly invoice. Contract logistics is different. The scope, the rates, the performance targets, and the exit terms are all written down before anyone moves a pallet.

That paperwork exists because the commitment runs both ways. You commit volume for years. The provider commits space, racking, equipment, and people to serve you. Both sides need to know what they are buying.

What work does a contract logistics provider actually do?

A contract logistics provider runs the physical work between your supplier and your customer. The usual scope covers five things:

  • Warehousing — receiving goods, storing them, and keeping them secure.
  • Order fulfillment — picking items, packing them, and handing them to a carrier.
  • Inventory control — counting stock and keeping the numbers accurate.
  • Returns management — receiving returns, inspecting them, and putting good stock back on the shelf.
  • Cross-docking — moving goods straight from the inbound truck to the outbound one, without putting them into storage.

Larger agreements add kitting, light assembly, labeling, and customs paperwork.

Contract logistics vs. 3PL — the same thing, or not?

The two terms overlap, and providers use them differently. Most sources treat contract logistics as one type of third-party logistics — the long-term, dedicated end of it. A third-party logistics provider can also work month to month. It can use shared space. It may ask for no long-term commitment at all.

Red Stag Fulfillment draws the line at resources and term length. It describes 3PL as shared, multi-client space on one-to-three-year contracts. It describes contract logistics as dedicated resources for a single client, on contracts of three to five years or more.

Other providers use the words to mean the same thing. CEVA, DHL, and Investopedia each define contract logistics simply as outsourcing logistics work to a third party. None of them require dedicated space.

So do not trust the label. Ask what is dedicated, how long the term runs, and who owns the assets.

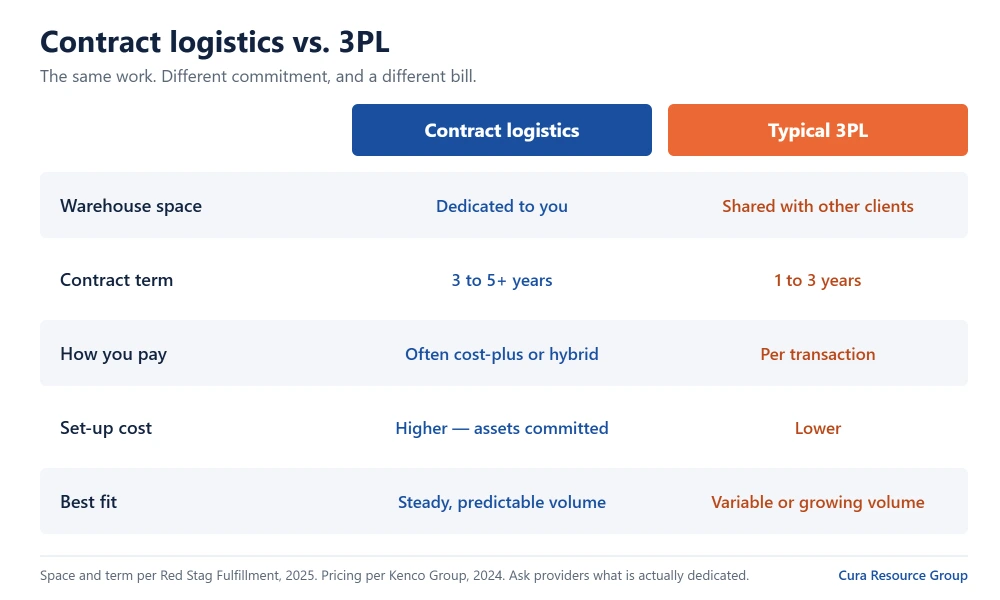

Comparison table. Contract logistics gives dedicated warehouse space on three to five year terms, often priced cost plus, with higher set up cost, and suits steady volume. A typical 3PL gives shared space on one to three year terms, priced per transaction, with lower set up cost, and suits variable volume.

Red Stag Fulfillment suggests contract logistics starts to make economic sense once annual logistics spend passes $500,000, though that is one provider’s threshold rather than an industry standard.

How contract logistics providers price the work

Most contract logistics deals price one of three ways. You pay a rate per unit of work, the provider’s costs plus an agreed margin, or a share of the savings. Those three appear in every published list. Beyond them, sources disagree on what the models are even called.

Consultancy Logistics Bureau names three core mechanisms in its March 2026 guide to 3PL warehousing contracts. They are percentage of sales, cost-plus, and rate-based. It then adds two variations you can bolt on to any of them: gain sharing and performance-based logistics.

Contract logistics provider Kenco Group names four in its February 2024 pricing guide. They are transaction and unit rates, fixed variable, open book or cost-plus, and outcome-based models.

Here is what each one means in plain terms:

Model How you pay Watch for
Rate-based / transactional A set price per unit, pallet, order, or shipment Out-of-scope work priced separately
Cost-plus / open book The provider’s actual costs, plus an agreed margin Costs can drift if nobody polices them
Percentage of sales A share of the sales value of goods handled Bears no relation to the work actually done
Fixed variable Fixed costs separated from variable costs Savings on fixed costs may stay with the provider
Gain share Savings above an agreed baseline get split Needs a year of baseline data first
Performance-based Fees tied to hitting performance targets Targets must be measurable and fair

Logistics Bureau founder Rob O’Byrne rates the rate-based structure as the best mix of the three. Setting the rates forces both sides to work out what the job really involves. It also forces them to agree volume break points up front.

Percentage of sales draws the sharpest criticism. Logistics Bureau calls it a “lazy” approach that may bear no relation to the resources and costs of the service provided. It also gives the customer no benefit when volumes rise.

Who owns the warehouse, the racking, and the WMS?

In multi-client and public warehousing, the provider owns all three. In a dedicated setup, you may own or lease the building and the equipment while the provider runs the operation. Most buyers forget to ask which one they are getting. Legacy Supply Chain Services set out the three standard options in a 2018 breakdown that still describes how the market works.

Dedicated warehousing. You or the provider owns or leases the building. The provider employs and manages the labor. Legacy Supply Chain Services puts these agreements at two to five years. Pricing runs on cost-plus, transactional, or hybrid terms.

Multi-client warehousing. The provider owns the building, the racking, and the handling equipment. It also owns the warehouse management system — the software that tracks where every item sits. You share all of it with other clients. Legacy Supply Chain Services notes these run month to month, priced per transaction or per pallet in and out.

Public warehousing. The provider owns everything. You get storage plus basic pallet in-and-out handling. Legacy Supply Chain Services describes it as month-to-month with no value-added services.

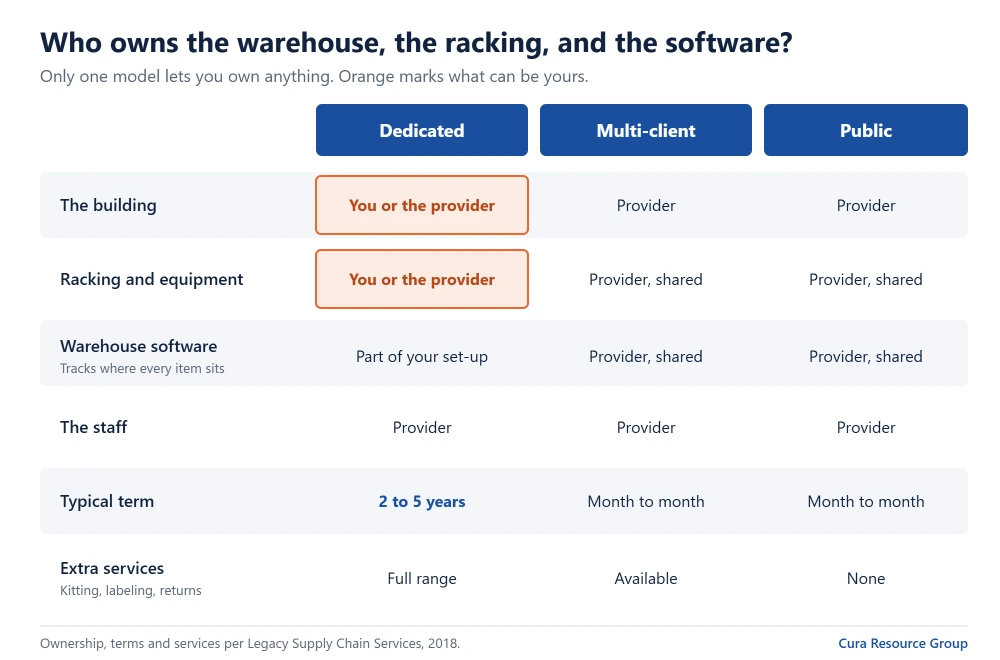

Comparison table of three warehousing models. In dedicated warehousing you or the provider can own the building and the racking, the term runs two to five years, and the full range of extra services is available. In multi client and public warehousing the provider owns the building, racking and software, and terms run month to month.

Yes, a provider can run a warehouse you already own. That is a common dedicated setup. You hold the lease and the assets. The provider supplies the management, the labor, and the processes.

How long is a contract logistics agreement?

Most run one to five years. The range depends on how much the provider has to invest up front. Logistics Bureau states that a 3PL contract can last from one to three years, with some going up to five.

The more dedicated the setup, the longer the term. Nobody buys racking, hires a team, and builds a software link for a twelve-month deal. Red Stag Fulfillment puts dedicated contract logistics at three to five years or more. It puts shared 3PL work at one to three years.

Watch the renewal clause as closely as the term. Fulfillment consultancy F. Curtis Barry & Company warns that the ninety-day non-renewal deadline is one of the most commonly missed dates in these agreements. Miss it and you roll into another full term.

The same firm recommends one of two exit routes. Ask for 180 days’ notice. Or ask for 90 days’ notice plus a guaranteed 90-day wind-down period. Either way, you can move without losing control of your stock.

What to check before you sign

Check the pricing definitions, the service levels, and the exit terms — in that order. F. Curtis Barry & Company lists 27 provisions worth negotiating in a 3PL contract, and the numbers it recommends give you a benchmark to negotiate against.

On pricing:

  • Every charge on the rate card should name its unit of measure. If you cannot trace a charge to a defined unit and an agreed rate, you cannot audit it.
  • Cap the annual escalator. F. Curtis Barry & Company notes vendors often word this as “up to 3%”, and recommends tying the increase to a published economic index rather than accepting a flat number.
  • Build volume tiers that move in both directions. The firm suggests a 15% volume drop as a repricing trigger. Rates should adjust when your business shrinks, not only when it grows.
  • Read the minimum charges and revenue commitments closely. They apply whether you ship or not.

On service levels:

  • Set the metrics by channel and by reporting period. F. Curtis Barry & Company gives inventory accuracy as an example, measured annually at 99.5%.
  • Make the remedies bite. The firm recommends credits of 5% to 15% of the charge on the affected order. Another option is 3% to 5% of all monthly order-processing fees.
  • An allowance sounds small until you size it. F. Curtis Barry & Company shows why. A 0.5% allowance is $10,000 against $2 million of average inventory. It is $100,000 against $20 million of annual throughput.

On invoices and exit:

  • Require transaction-level detail on every invoice.
  • Check the dispute window. The firm warns it is commonly only 5 to 15 days after receipt. That is rarely long enough to catch an error.
  • Agree the wind-down terms before you start, at current rates. Nobody negotiates well while leaving.

Build the statement of work from real data, not estimates. F. Curtis Barry & Company recommends at least twelve months of transaction-level history. That way the rates reflect your actual order profile.

What happens between signing and go-live

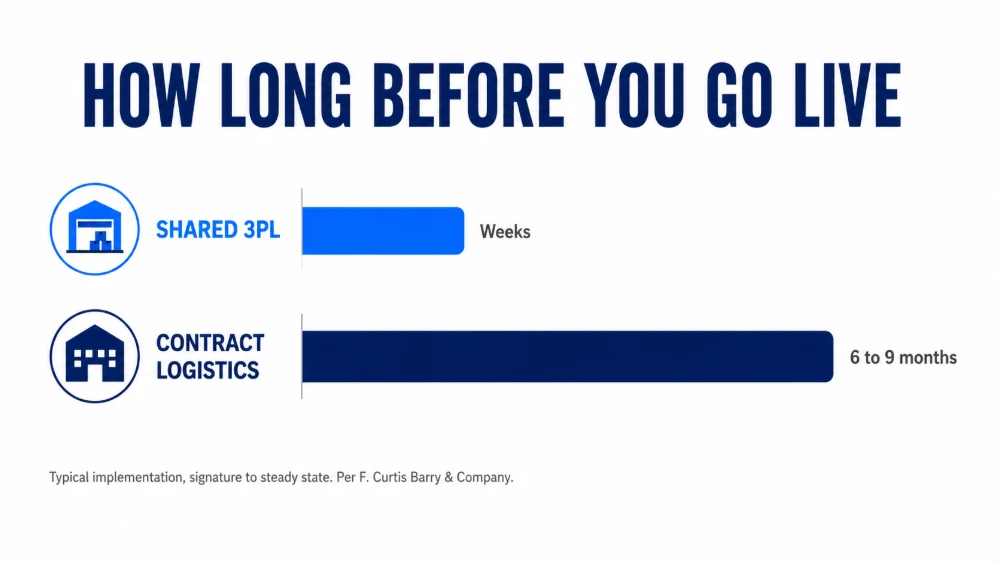

Expect months, not weeks — F. Curtis Barry & Company puts a typical implementation at six to nine months, from signature to steady-state operation.

The time goes into systems and stock, not paperwork. Your order data has to flow into the provider’s warehouse management system. Inventory has to be counted, moved, received, and put away. Processes have to be documented and staff trained on them.

Receiving is slower than most people expect. F. Curtis Barry & Company notes that mixed inventory takes 1.5 to 2 times longer to receive than clean, single-SKU pallets.

Service levels usually do not apply from day one. The same firm reports that a 30 to 90-day suspension of SLA remedies during the ramp period is common — reasonable while the operation settles, but the end date belongs in the contract.

Plan the transition for your quiet season. Moving a warehouse during peak is how brands miss Christmas.

Why brands outsource this work at all

The case rests on cost, capacity, and productivity. US ecommerce sales reached $340.2 billion in the second quarter of 2026, 17.1% of all retail sales and up 12.2% year on year, according to the U.S. Census Bureau’s release of 18 August 2026. Order volumes are still climbing.

Labor is the pressure point. The Bureau of Labor Statistics put average warehousing and storage wages at $26.85 an hour in June 2026. That is the number that decides whether your own operation is cheaper than a provider’s.

The productivity trend is the strongest argument, and almost nobody cites it. Bureau of Labor Statistics figures show labor productivity in warehousing and storage fell 11.5%, 11.0%, and 4.4% in 2021, 2022, and 2023, then rose just 0.1% in 2024. Warehouses have been getting less efficient, not more. Running one well is harder than it looks.

If you are still weighing whether to outsource at all, our comparison of 3PL versus in-house fulfillment works through the cost side, and our guide to choosing the right 3PL partner covers how to run the selection.

Contract logistics with Cura Resource Group

Cura Resource Group runs warehousing, order fulfillment, inventory control, returns management, and cross-docking. We work with B2B, wholesale, and ecommerce brands. Our contract logistics services page sets out the full scope.

Want to see how the numbers work for your volume and order profile? Get a quote and we will build one against your own data.

Related reading: what a 3PL provider does · supply chain logistics · warehouse management · how a fulfillment center works

Frequently asked questions

What does contract logistics mean in simple terms?

It means paying an outside company to run your warehousing and shipping under a written, long-term agreement. You keep ownership of the stock and the customer. The provider supplies the building, the staff, and the systems, and has to hit the service targets you both agreed.

Is contract warehousing the same as third-party logistics?

Not quite. Contract warehousing usually means dedicated space and a multi-year commitment. Third-party logistics is the broader term. It often means shared space on shorter, more flexible terms. Many providers use both words loosely. Ask what is dedicated rather than trusting the label.

Can a provider operate a warehouse my company already owns?

Yes. In a dedicated setup you can hold the building lease and own the racking and equipment. The provider supplies management, labor, and day-to-day processes. Legacy Supply Chain Services lists this as one of the standard dedicated warehousing structures. Ask any provider whether it will operate on your site.

How much do contract logistics providers charge?

It depends on the pricing model. Rate-based deals charge a set price per unit, pallet, or order. Cost-plus deals charge the provider’s actual costs plus an agreed margin. Ask which model applies, then ask for a worked example against twelve months of your own order data.

What service levels should a logistics contract include?

At minimum, order accuracy, inventory accuracy, and on-time shipping, each measured by channel and reporting period. F. Curtis Barry & Company gives inventory accuracy measured annually at 99.5% as one example. Make sure the contract also states what you get paid if the provider misses.

How long does it take to move to a new provider?

Longer than most brands plan for. F. Curtis Barry & Company puts typical implementation at six to nine months from signing to steady state. Systems integration and inventory transfer take the bulk of that. Schedule the move outside your peak season.

What is the shortest commitment I can make?

Public and multi-client warehousing usually run month to month, according to Legacy Supply Chain Services. Dedicated contract logistics rarely does, because the provider is committing space, equipment, and staff to you alone and needs time to recover that investment. If you need flexibility, ask about shared space instead.

What is the most commonly missed clause?

The non-renewal deadline. F. Curtis Barry & Company flags the ninety-day notice date as one buyers routinely miss, which rolls them into another full term. Diary it the day you sign, not the month it falls due. Set a reminder ninety days before that, too.
